Why West African Mobility Fails: The Hidden Friction of Fragmented Governance

Why West African Mobility Fails: The Hidden Friction of Fragmented Governance

Beyond the Visa Stamped in the Passport

Mobility failure in West Africa is a misdiagnosis. Management is prone to the delusion that assignment delays are merely the product of sluggish immigration bureaucracy or the whims of a consular official. However, a pragmatic analysis of compliance gaps, the kind typically uncovered during high-stakes audits and remediation projects, reveals a more uncomfortable truth: these are not failures of “immigration rules,” but systemic breakdowns in the governance between immigration, payroll, and tax functions.

When a corporate assignment in Nigeria or Ghana stalls, it is rarely because a visa could not be obtained; it is because the organisation failed to reconcile the regulatory requirements of three distinct government silos. True mobility success in this region is a function of cross-functional governance, not administrative speed.

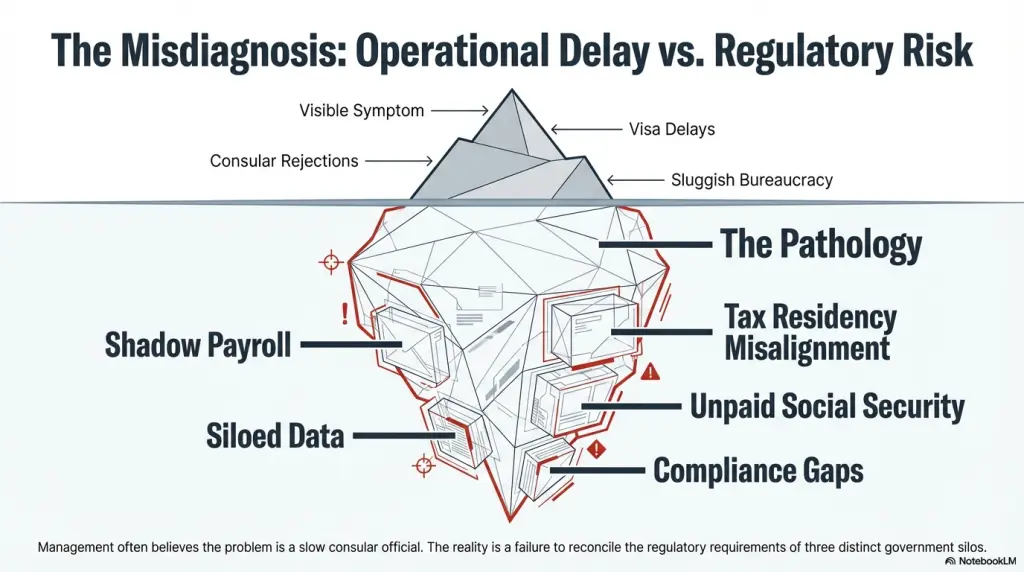

The misdiagnosis: operational Delay vs Regulatory Risk

Nigeria’s CERPAC and Ghana’s Residence Frameworks

The regulatory landscapes in Nigeria and Ghana have evolved into sophisticated frameworks designed to enhance government visibility, often at the expense of corporate agility.

Nigeria

The Combined Expatriate Residence Permit and Alien Card (CERPAC) is the cornerstone of visibility. However, its issuance marks the end of a long chain that begins with the Temporary Work Permit (TWP) pre-approval or the stringent Nigerian expatriate quota system. If the upstream quota approval is missing or documents are inconsistent, the system grinds to a halt.

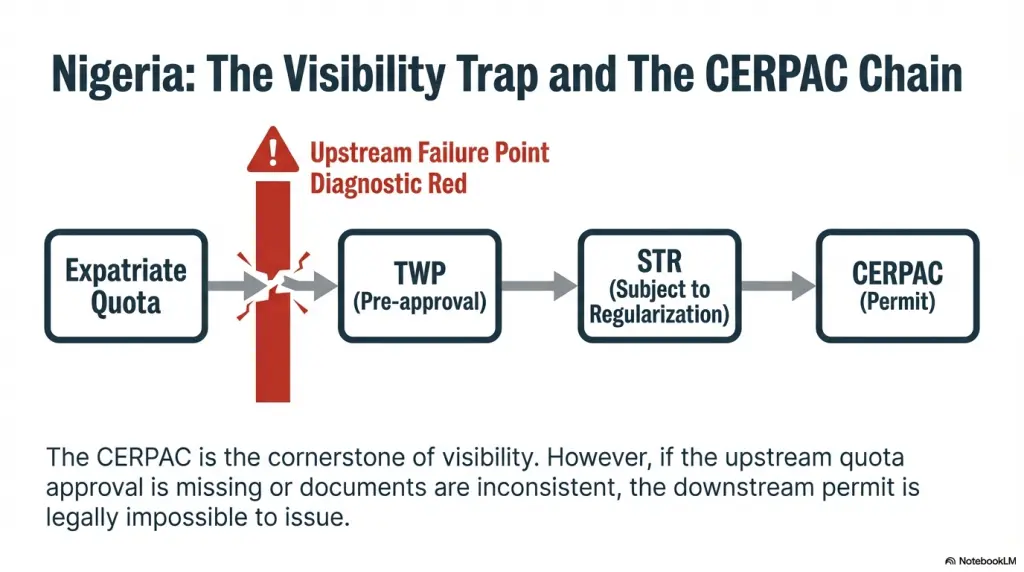

Nigeria - the visibility trap and the CERPAC chain

Ghana

The framework requires a complex sequence starting with GIPC (Ghana Investment Promotion Centre) registration. Only after this hurdle is cleared can a Work and Residence Permit be considered.

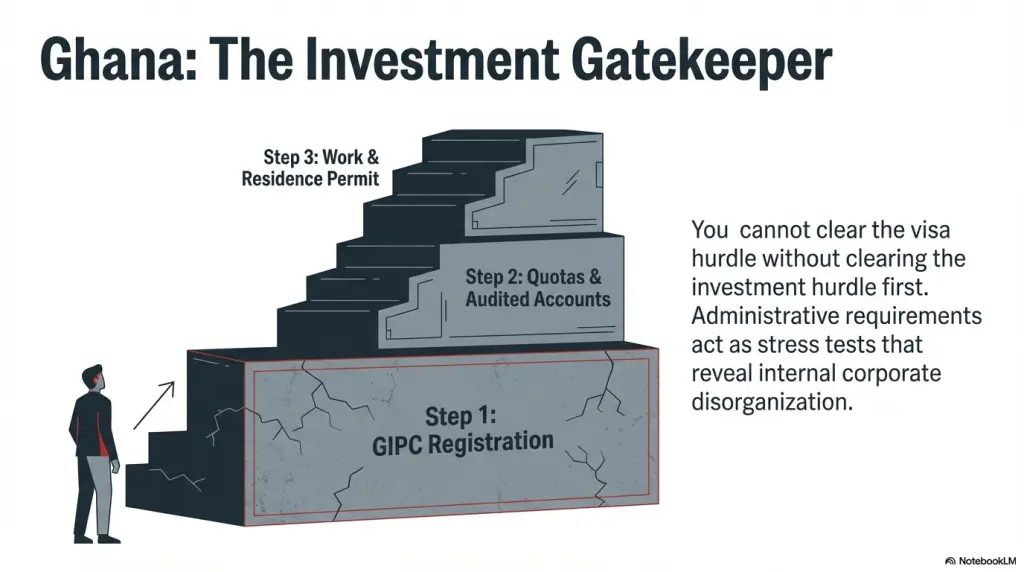

Ghana - The investment gatekeeper

What This Means

These systems prioritise state control over business cycles. For a multinational, the administrative requirements (such as audited accounts and tax clearance certificates) act as stress tests that frequently reveal internal corporate disorganisation.

The Compliance Risks of Cross-Border Assignments

The most significant threats to regional operations are silent risks – liabilities that accumulate unnoticed until an enforcement action triggers a catastrophic failure.

Risk Category Governance Gap Audit Exposure
Shadow Payroll & Offshore Remuneration Partial remuneration is paid outside the host country (e.g., Nigeria or Ghana) without local payroll alignment. Revocation of expatriate quotas (Nigeria); criminal prosecution for tax evasion; and corporate blacklisting.
Tax Residency Misalignment The “Residence Permit Fallacy”: assuming a permit determines tax status rather than statutory physical presence triggers. Double taxation; massive interest back-charges; and corporate blacklisting by the Revenue Service.
Social Security Exposure “Decent work deficits” (ILO) and lack of portability for accrued benefits under the SADC Cross-Border Portability Framework. Unfunded long-term liabilities; exclusion from local protection; and severe financial penalties for non-contribution.

Introducing the Shadow Payroll Governance Model

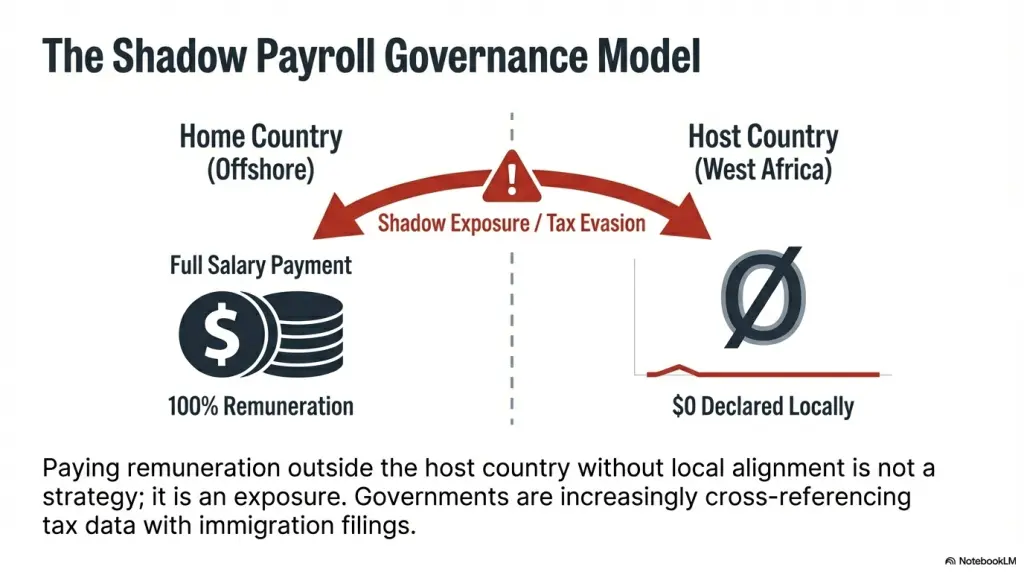

The shadow payroll governance model

The historical tendency to silo mobility as a clerical HR function is a primary driver of financial exposure. To survive, organisations must shift mobility data “upstream,” reclassifying it as a “compliance domain.”

A robust governance framework requires a “single source of truth” shared between HR, Payroll, Tax, and Immigration. Governments now have the tools to cross-reference data; therefore, a company’s internal data must be integrated as well. This flow must include:

  • Real-time tracking of travel dates to monitor statutory tax residency triggers.
  • Precise remuneration splits (onshore vs. offshore) to ensure payroll alignment.
  • Automated alerts for permit expirations linked to project delivery timelines.

Failure to synchronise these data points is the primary cause of downstream administrative failure.

External Pressures as Risk Multipliers

External red tape and geopolitical instability do not cause mobility failure; they serve as stress tests that reveal existing internal weaknesses. While frustrating, this bottleneck exposes companies that lack the upstream coordination to manage long lead times.

Heightened scrutiny of third-country visa processing or delays in government vetting are risk multipliers. If your internal coordination is poor, a minor shift in a host country’s immigration policy can bring an entire multi-million dollar project to a standstill.

Deconstructing Common Employer Misconceptions

Mobility Failure - what we think vs what audits show

Three persistent myths continue to undermine West African mobility strategies:

The Residence Permit Fallacy

The belief that holding a permit settles your tax status. In reality, a permit is merely an authorisation to stay. Tax residency is triggered by statutory presence laws, which often apply regardless of whether the permit has been finalised.

The Payroll Silo

Treating remuneration as independent of immigration risk. Authorities in Ghana and Angola increasingly demand evidence of tax and social security compliance as a non-negotiable prerequisite for permit renewals.

The Declaration Trap

Relying on expatriate self-declarations for travel dates and compliance. This is a high-risk strategy. Compliance must be managed through system-level controls and verified data.

The Operational Bottleneck

Operational lead times are frequently extended by months due to poor document governance.

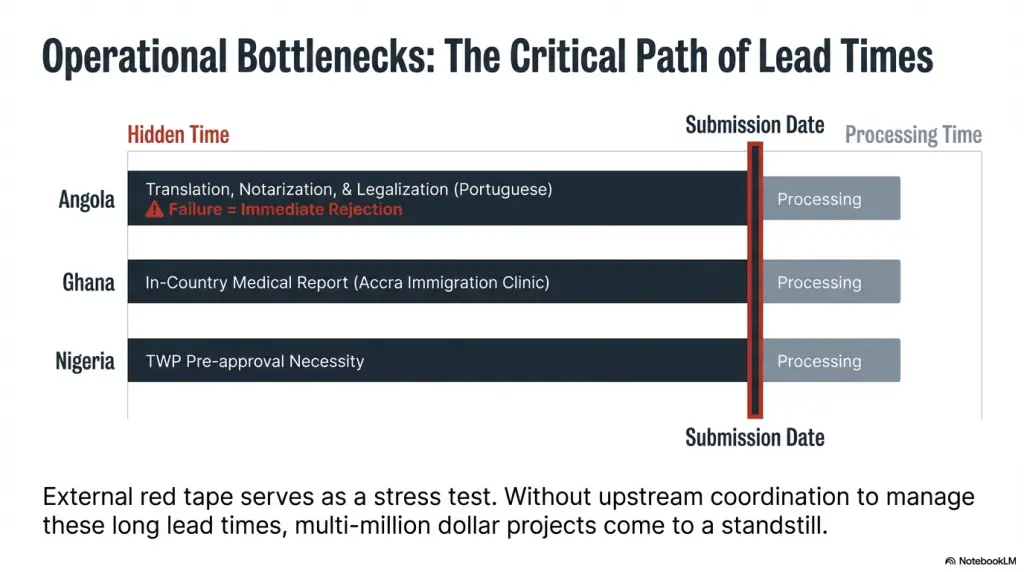

Operational bottlenecks - the critical path of lead times

Ghana

The medical report requirement is a critical path bottleneck, as it must be obtained directly from the Ghana Immigration Clinic in Accra.

Nigeria

The Temporary Work Permit (TWP) requires a pre-approval necessity that many firms fail to initiate early enough in the recruitment cycle.

Angola

This is perhaps the most demanding jurisdiction. Documents must not be notarised, translated into Portuguese and legalised by the Foreign & Commonwealth Office (or equivalent) before submission. Failure to follow these exact steps results in immediate rejection and stalled projects.

Redesigning West African Mobility Governance (3–5 Year Outlook)

Multinationals must move toward a digitalised, integrated governance model to remain viable in the region.

Functional Reclassification

Formally move mobility under the Legal or Compliance umbrella. Treating it as a clerical HR service ignores its status as a high-stakes regulatory risk.

Data Integration

Merge immigration data directly into payroll and tax review cycles. Cloud-based tools must replace manual spreadsheets to provide a real-time view of shadow exposures.

Strategic Regional Hubs

Companies often view Ghana as a low-risk hub for West African operations. However, using Ghana to support a Nigerian project creates a double-compliance burden. Unless your upstream data is unified, you are merely doubling your risk exposure across two jurisdictions.

From Administrative Task to Strategic Compliance

The number of visas stamped does not measure the success of a mobility programme in West Africa, but rather the integrity of the underlying governance. Organisations that treat immigration as an isolated task will continue to face friction, delays, and corporate blacklisting.

Senior management must audit their shadow exposures (specifically in payroll and tax alignment) immediately.

Audit your systems now, before the following enforcement action audits them for you.

Written by Melissa Moses, Senior Immigration Manager, Africa
